Civilengineer friend no one website Civil engineering Subjects tutorial Learn Civil Engineering online Building construction Building material Bricks Cement Concrete technology Irrigation engineering R.C.C. Structure design Limit State Method Working Stress method Strength of material SFD and BMD Surveying Theory of structure Architects I Engineers I Developer Assure Quality With Excellence

test banner

Thursday, 20 February 2020

DMC piling method procedure

DMC piling method procedure

Direct Mud Circulation method of pile foundation installation is used for bored cast in-situ piles. Direct Mud Circulation method is best suited when working-space is a huge constraint. In Industries and power plants where there is a labyrinth of pipelines snaking all around, DMC comes to the rescue.

The whole project report is subdivided in the following
sections:
1. Introduction
2. Objectives and classification of piles and piling
methods
3. Principle of DMC piling
4. Apparatus used
5. Field procedure DMC piling

6. Conclusion

1. INTRODUCTION
Piles are the columnar structure, the most common type of
deep foundation, that safely transfer loads from the super
structure to more competent subsurface strata by means of
friction, end bearing or a combination of both. Piles can be
broadly classified based on the following parameters.
1. Method of installation of piles – Driven (displacement) piles
or bored (replacement) piles.
2. Type of material used for piling – Concrete, steel, timber
piles etc.
Among these, concrete piles can be classified further as precast
and cast in situ concrete piles. Though there are a variety
of piling options, the most common type of piles used for
majority of construction works in India are bored cast in situ

concrete piles.
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works
2. Objectives and classification of piles and piling methods Functions of piles:

The major uses of piles are:

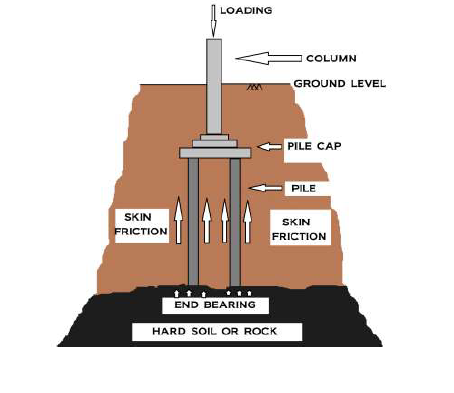

1. To carry vertical compression load, eg. bearing piles,
friction pile. (FIG. 1)
2. To resist uplift pressure, eg. tension piles or uplift piles or
anchor piles. (FIG. 2)
3. To resist horizontal or inclined loads, eg. Batter piles.
(FIG. 3)
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works
Setting up piles
Depending up on the setting up principle, piles can be of two types, eg. Displacement type and Replacement type, each has its own advantages and disadvantages. For displacement piling
method, piles are driven into the ground pushing the soil out of its way. Displacement piling is good for contaminated sites where it costs a lot to move the soil out.
Using the replacement piling method, muck is dug out and replaced with the pile. Much bigger piles can be casted by replacement method.
Direct Mud Circulation (DMC) piling method or simply DMC Piling method is an example of replacement piling method. This method is the principle subject of interest in this report.
The advantages of displacement piling are:-
 Self testing as driven to refusal or "set"
 No pile arising to dispose of
 Little disturbance
 Limited access
 High production
The disadvantages of displacement piling are:-
 Cannot penetrate obstructions
 Cannot always penetrate desiccated clay
 Vibration and noise may be an issue
The advantages of replacement piling are:-
 Effectively vibration free
 Installed into non cohesive and water bearing soils
 High production
 Restricted access
The main disadvantage of replacement piling is that:-
 it produces excavated material which requires removal off site

3. Principle of DMC piling
DMC piling is a typical wash bored piling method, ie. the piles are of REPLACEMENT type. For this type of piling method, the sub soil must be of cohesive nature. The basic principle of DMC piling
lies in the fact that the soil layers becomes harder to penetrate with depth, so to soften the hard soil layers deep below the ground level,water jet streams are used and then a typical chisel cuts the
relatively softer soil. Bore holes of several depths (for example 10m,15m, 20m, 25m, 30m, etc.) and diameter (for example 500mm 750mm, 1000mm etc.) are dug as per design requirements. It can be
understood quite clearly that the nearby soil can collapse. To prevent the collapse some special safety measures are considered during the operation which will be discussed in later sections. After the bore hole is dug and the collapse of subsoil around the hole is safely prohibited, a reinforcement cage is entered into the borehole and concrete is filled from the bottom of the hole with the help of pipes, typically designed for this operation, called the Tremie pipes. Usually concrete is left 28 days to harden and gain full strength, but sometimes using admixtures they are prepared within 21 days.

4. Apparatus used
I. DMC rig
 THE TRIPOD SYSTEM
Main shear leg: it is the longer leg than the other two that carries the load.
The length is 7.5m. The length can be adjusted. With the help of 20mm dia pins

The side shear legs: there are two side shear legs, 6.3m long
and they mainly support the tripod system.
The side legs must be placed at least 1.5m away from the centre
of the piles.
 BASE CHANNEL
These are standard I section, 2cm thick and there are grooving in it that holds the shear legs onto the ground with the help of base cannel pin.

      SLIP OVER WHEEL
Diameter
450mm
Thickness
50mm
Operation
The rope slips over this wheel or Pulley



      S.O. WHEEL PIN
Diameter
65mm
Length
200mm
Operation
This is very important pin, because it holds the S.O. Wheel with the tripod system and the entire vertical loads act on it.

SLIP OVER WHEEL
      SLIP OVER WEEL HOLDER
Diameter = 500

      PLUNGE
Inside Diameter = 50mm
      SUSPENSION PLATE – this is called into action if somehow the chisel is stuck in the borehole. Pulleys are attached here and the chisel is pulled out.
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works
                                                              Suspension Plate
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works
      MAIN SHEAR LEG PIN – 20mm dia.


II.       Winch
Capacity
3 Ton (Other capacities can be of
1 Ton 2.5 Ton 5 Ton 7.5 Ton etc.)
Driven wheel diameter
900mm


II.       Diesel engine       USED IN WINCH (RUSTON MAKE)
Number of cylinder
4
3
Diesel consumption
2.1 lit/hr
1.75 lit/hr
Mobil consumption (fresh engine)
0.5 lit per 7 days
0.5 lit per 7 days
Mobil consumption (older engine)
0.5 lit per 12 hours
0.5 lit per 12 hours
       USED IN PUMP (KILOSKER MAKE)
Number of cylinder
2
Diesel consumption
1.25 lit/hr
Mobil consumption
250ml per 12 hours

IV.       Bailer or Slush Pump
Length                                                                   2700mm
Inside Diameter                                                   450mm
Weight                                                                  0.5 Ton
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works

V. Guide casing
Length                                                                     2750mm
Inside Diameter                                                     550mm
Thickness of casing                                               30mm
Thickness of collar                                                20mm

VI. Chisel or Chopper
Thickness of sheet                                                 80mm
Inside Diameter                                                      400mm
Length                                                                      2500mm
Number of nozzle                                                   4


piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works
7.   DMC rod
Length (m)
2.7                   3                    3.25
Diameter (mm)
95                    75                   65
Thread length (mm)
120
Thread type
Tapered
ID of tapered king end (mm)
80
ID of queen end (mm)
120

piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works

 Tapered thread end of DMC rods
7.                          Rope
Diameter – 20mm


8.                          Tremie pipe
ID
5 inch
OD
6 inch
Thickness of sheet
12mm

9.                          Vertical pump
Power source
Electrically operated
Power
10 Hp

10.                   Bentonite tank and Bentonite slurry
The Bentonite tank stores the Bentonite water which is of avg. Density of 1.04gm/cc. The minimum density is 1.03gm/cc and maximum density is 1.05gm/cc
Vertical Pump in Bentonite tank
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works

7.                          Wash vat
This is where the muck mix with water gets stored, the muck gets precipitated and the water becomes reusable.

8.                          Tremie fork
Used to insert the tremie pipes and taking out DMC rods.
piling,dmc pile method,dmc piling,dmc pile,dmc,bored piling method,tripod piling method,method of dmc pile,rmc method of piling,pile foundation,pile work procedure,piling process,pile boring methods,piling process site work,piling services,piling services provider,bored pile,tmr piling machine,dmc pile bentonite hydrometer,piling work,dmc pile full form,micro piling,piling works

            5. Field procedure DMC piling


      For executing DMC piling method which is approved as per IS 2911 under specifications of bored cast in situ piles. The positioning of points where the piles are proposed to set up, are checked by the surveyor.

Ø DMC piling Rig set-up and initiation of boring using the Bailer

      After the point for boring operation is set out by the surveyor the tripod is paced such that each side legs are at least 1.5m away from the point, keeping the centre of borehole exactly in the centre.
      The bailer is then attached with the rope and the boring operation is initiated.

      After bailer reaches its full length into the soil, the guide casing is inserted into the hole for farther operations.

Insertion of the guide casing


To prevent the side collapse and caving in, a guide casing of 550mm dia and of 2750mm length is placed on the top of the bore hole and hammered by the bailer to insert it into the soil. This will be withdrawn after concreting is over.


        Ø         Boring with Chisel

      Once the guide casing is placed, the boring is started with chisel.
      The chisel has 4 nozzles from where water jet is forced on the hard soil layer as the boring progresses.

Ø Progression of boring and addition of DMC rods


      DMC rods are added one after another as the depth increases.
      The DMC head are attached on top of the DMC rods which has the plunge which receives the water from delivery hose.
      The whole system is pulled up by the rope and the D-Shackle with the help of the winch system and then left to fall free, so that the chisel at the bottom cuts the soil and the boring progresses.
      The loose soil produced by boring, mixes with water and comes up and is stored in the wash vat, where the soil gets precipitated and the water is again usable.

Ø Taking out of the DMC rods and Chisel and Insertion of the reinforcement cage

      After the boring is complete up to the desired depth, the DMC rods are removed one by one using the DMC fork and the chisel is also removed.
      Then the steel reinforcement cage is inserted and welded where ever there are joints.

Ø  Concreting and finalization of the process


      The tremie pipes are inserted one by one using the Tremie fork and then the bore hole is washed with the Bentonite water and the Muck is completely removed and the hole is filled with bentonite slurry.
      The Transit mixer arrives and the Hopper is attached on top of the tremie pipe.
      The TM puts concrete mix into the hopper and the valve opens. The bore hole is gradually filled with concrete which is
compacted by gradual vibration of tremie pipes. This filling of concrete from the bottom is done to avoid segregation of the concrete mix.
      As the concrete fills the hole from bottom, Bentonite slurry escapes the hole. The tremie pipes are detached one by one and thus the hole gets filled completely.
      After the hole is fully filled, the concrete is left 28 days to gain full strength. After 28 days the guide casing is removed and the pile is ready.


6. Conclusion


DMC piling is the most common piling methods used in India. For moderate sized piles, that is 450mm to 1000mm diameter and 25m to 30m depth piles; it is also most convenient and economic way of piling. Larger piles that are of diameter up to 1500mm can also be founded by this method, but those are not that convenient. Other process like Reduced Mud Circulation (RMC) is also in use.
